Engineering basis

The evidence question is not whether foam exists. It is whether the installed system can provide controlled support, restraint and verification in the project context.

Structural PU foam support

The method uses structural polyurethane foam as part of a defined keyhole support and restraint geometry.

Compression and shear behaviour

Foam behaviour must be assessed against project-specific loads, support geometry, installation sequence and long-term assumptions.

Restrained pipeline behaviour

HydroFoamer is focused on restrained buried pipelines where support, bends, movement and coupling behaviour are central design questions.

Load distribution

The support geometry, native backfill interaction and pipe system determine how loads are distributed around the installed pipe.

Creep considerations

Long-term behaviour requires engineering review. HydroFoamer does not remove the need for project-specific material and design validation.

Installation geometry

Measured pipe position, alignment and coupling deflection help connect the installed condition to the engineering model.

“For pipeline installations carried out using the HydroFoamer restrained installation method, where pipe alignment, movement, and settlement are controlled and verified throughout the length of the pipeline during installation; the designer may consider the nominal joint deflection capacity of the pipe system, as the restrained installation conditions significantly reduce the uncertainty factors typically associated with conventional buried pipe installation.”
Future Pipe Industries

Why this matters

Control reduces uncertainty

Conventional buried pipe installation carries uncertainty from trench geometry, bedding quality, compaction, pipe movement, settlement and site execution. HydroFoamer changes those assumptions by controlling and verifying pipe alignment, movement and settlement during installation.

This recognition matters because it links the construction method to the design assumptions behind buried composite pipe systems.

Measured installation

HydroFoamer is not only a material substitution. It is a controlled installation method with evidence attached to it. The evidence should answer practical questions before the installed condition is hidden.

Pipe position

Measured position records help confirm where the pipe sits before and during support installation.

Alignment

Alignment checks support field control before conditions are hidden by backfill.

Coupling deflection

PGMS-enabled checks can support review of angular position and coupling geometry.

Movement and settlement

Measured installation control is intended to reduce uncertainty from pipe movement and settlement during installation.

Installation record

Records can connect survey, foam application, QA/QC and installation hold points.

As-built evidence

PGMS, Leica / total station integration and BIM / digital twin handover can create auditable as-built records.

What the evidence should prove

Evidence is useful when it reduces a decision-maker's uncertainty. It should connect the engineering model, the field condition and the handover record.

Was the pipe where it was meant to be?

Alignment, position and coupling geometry records help connect design intent to the installed condition.

Was the support geometry installed?

Foam application records and field checks should show the support sector and keyhole geometry used on the project.

What moved during installation?

Movement and settlement observations help distinguish controlled installation from assumptions made after backfill.

What quantities changed?

Imported aggregate, native backfill, foam volume and spoil movement should be traceable to the project comparison.

Who accepted each hold point?

QA/QC records should identify checks before foam application, before backfill and at as-built handover.

What remains project-specific?

Engineering, geotechnical, contractual and regulatory validation remain attached to the actual route and pipe system.

Published evidence materials

Field history, academic review and regulator-facing briefing material

These documents show HydroFoamer moving through field application, academic discussion and structured safety review. They are evidence inputs for project-specific review, not universal design standards.

Preview of the HydroFoamer NVE technical briefing title slide.

Regulator-facing briefing

NVE technical briefing, 2026

A HydroFoamer information deck prepared for a meeting with NVE on the use of PU foam around composite pipe routes, with emphasis on safety assessment and documentation.

  • Frames the verification chain from theory, modelling and laboratory work through Adamselv field operation.
  • Covers load transfer, long-term behaviour, field QA, process control, environmental stability and robotic application.
Download NVE briefing deck

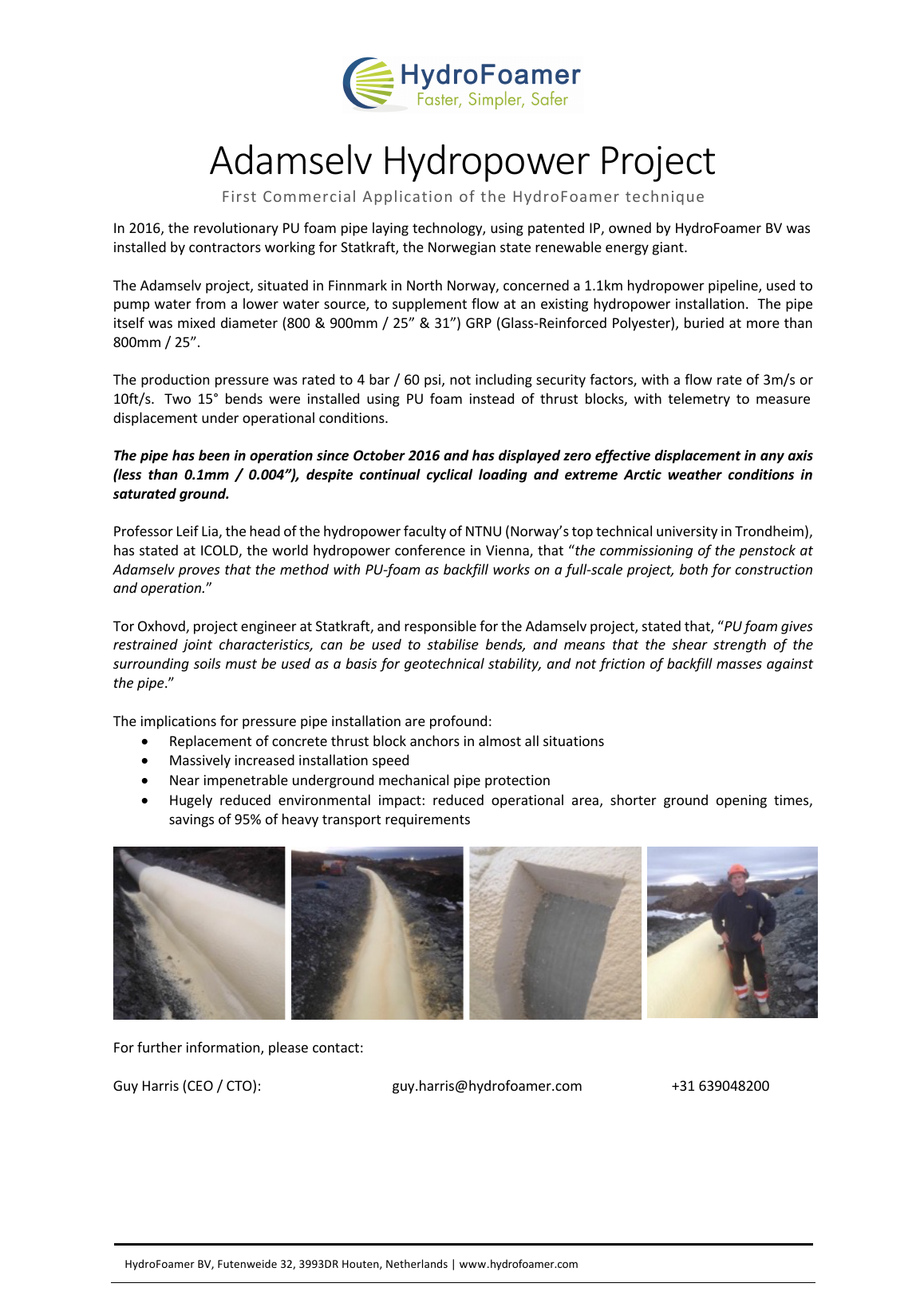

Preview of the HydroFoamer Adamselv hydropower project note.

Field history

Adamselv hydropower project

A historical project note on the 2016 Adamselv / Lille Måsevann installation in Finnmark, describing a full-scale composite hydropower pipeline context and monitored bends installed with PU foam.

  • Important as the first commercial application of the HydroFoamer technique.
  • Shows field use in remote northern conditions with operational monitoring forming part of the evidence base.
View Adamselv project note

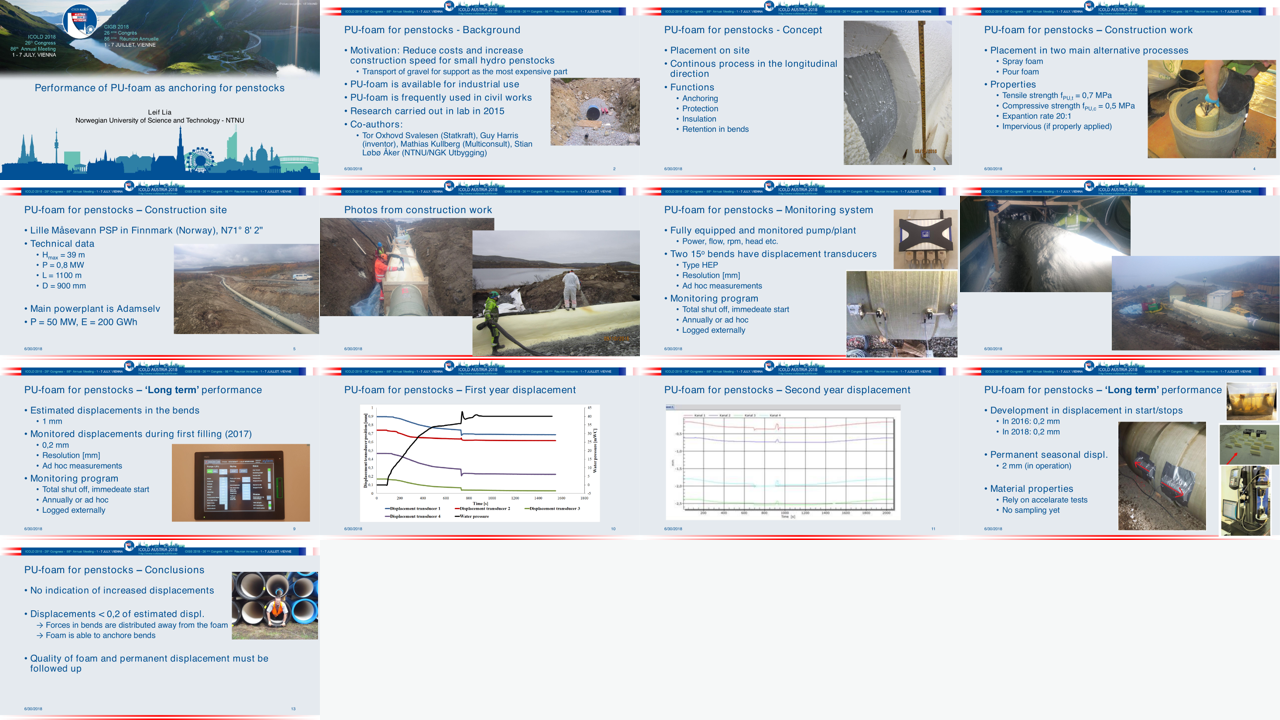

Preview contact sheet of Professor Leif Lia's ICOLD 2018 presentation on PU foam for penstocks.

Academic dissemination

Professor Leif Lia at ICOLD 2018

Professor Leif Lia's NTNU presentation to ICOLD 2018 placed PU foam anchoring for penstocks in an international dam and hydropower engineering forum.

  • Explains the motivation, concept, construction process, monitoring system and Adamselv field context.
  • Connects HydroFoamer's early field evidence with academic hydropower engineering discussion.
View ICOLD 2018 presentation

The NVE briefing is evidence of structured technical engagement; it should not be read as regulatory approval. Adamselv, ICOLD and NVE materials remain context-specific and do not replace detailed engineering, geotechnical, contractual or regulatory validation for new projects.

Project engineering example

Eikeelva trench section with foam support

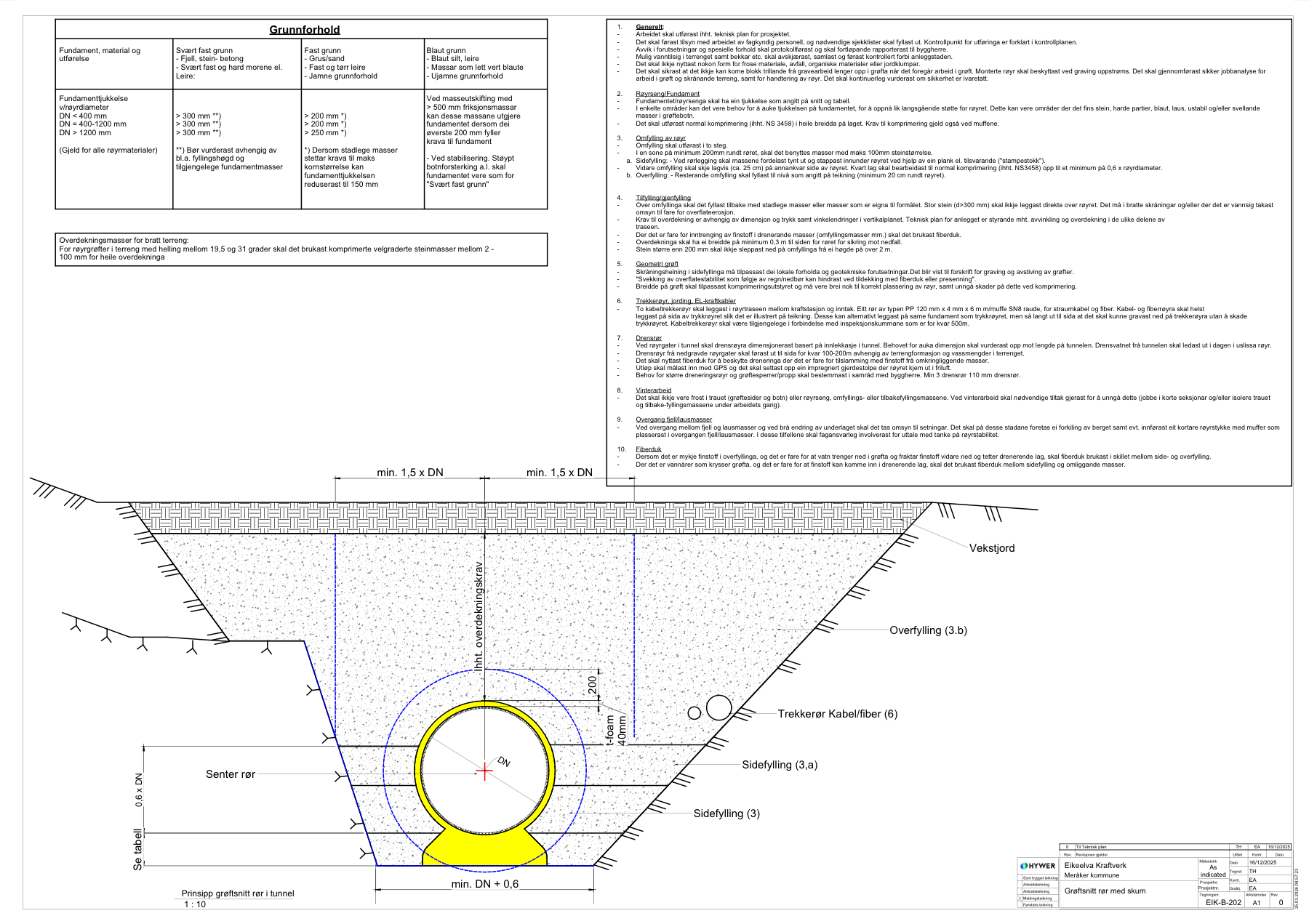

This technical-plan excerpt from Eikeelva shows a project-specific trench cross-section for a HydroFoamer installation in Norwegian mountain terrain.

The drawing matters because it shows the method becoming an engineered installation detail: pipe position, sidefill, overfill, sprayed PU foam support and construction geometry are treated as one system.

This is a project-specific engineering example, not a universal trench standard. Future projects require their own engineering, geotechnical, contractual and regulatory review.

View Eikeelva trench section PDF
Preview of the Eikeelva technical plan trench section showing a pipe supported with sprayed PU foam in a mountain trench.

Project and test evidence

Evidence must stay attached to context

Project and test evidence should be linked to the actual pipe system, trench geometry, soil context, installation method, foam design and acceptance requirements. Published materials support the evidence pathway, but new projects still require their own qualification.

  • Public materials now include the Adamselv project note, Professor Leif Lia's ICOLD 2018 presentation, the Eikeelva trench section and the NVE technical briefing deck.
  • The NVE deck organises safety discussion around theory, calculation, laboratory testing, field operation, long-term behaviour, QA and environmental controls.
  • HYWER-type project calculations, foam thrust-block testing and detailed engineering modelling may be reviewed through technical briefing or NDA-controlled discussion where appropriate.
  • PACE outputs can document the assumptions behind cost, programme, material movement and sustainability comparisons.
  • Evidence supports review and handover; it does not replace detailed engineering, geotechnical, contractual or regulatory validation.

Request evidence for a specific context

Ask for the evidence pathway relevant to your pipe system, installation constraints, qualification needs and commercial scenario.

Request Technical Briefing
